Ginza 2019 Setup/Breakdown Tasks by Day
Thank you for helping with Ginza Setup and Cleanup! Use this page as an outline for the tasks we need to complete each day to prepare for Ginza. For our regular setup activities* lets start with the basics:
Schedule of days we need setup volunteers:
- Aug 3 – Saturday before Ginza from 9:30 am to 3:00 pm
- Aug 4 – Sunday before Ginza from 11:30 am to 5:00 pm
- Aug 5 – Monday before Ginza – CONTINGENCY: only needed if we are rained out on either Saturday or Sunday
- Aug 6-8 – Tuesday-Thursday before Ginza – 5:00 pm to 8:30 pm
- Aug 12 – Monday after Ginza – Cleanup 9:30 am to 5:00 pm (unless we finish earlier)
- *Actually, Ginza outdoor setup tasks begin in July with some prep work like building booth frames and the stage superstructure – if you have a flexible schedule and would like to help contact Roger or Jerry
Volunteer Saftey!
- Please think safety as you to plan to help with setup – some things you might consider bringing:
- Hat, work gloves, knee pads, appropriate shoes (no sandals)
- Water; we will provide water but it’s up to you to STAY HYDRATED
- Tools; if you bring your own tools remember to mark them so they don’t get lost
[ap_column_wrap]
[ap_column span=”2″]
[ap_divider color=”#a17f0d” style=”solid” thickness=”2px” width=”100%” mar_top=”20px” mar_bot=”20px”]
Saturday the week Before Ginza
Focus: GARAGE PREP, STAGE SETUP, ELECTRICAL

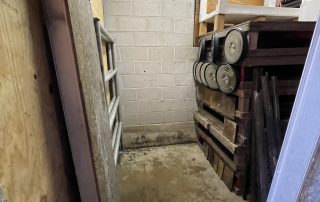

- Open space along the west wall
- Install window air-conditioner
- cover chicken prep area (floor to ceiling) with plastic
- Cover all floor space with cardboard
- Cover east wall with cardboard

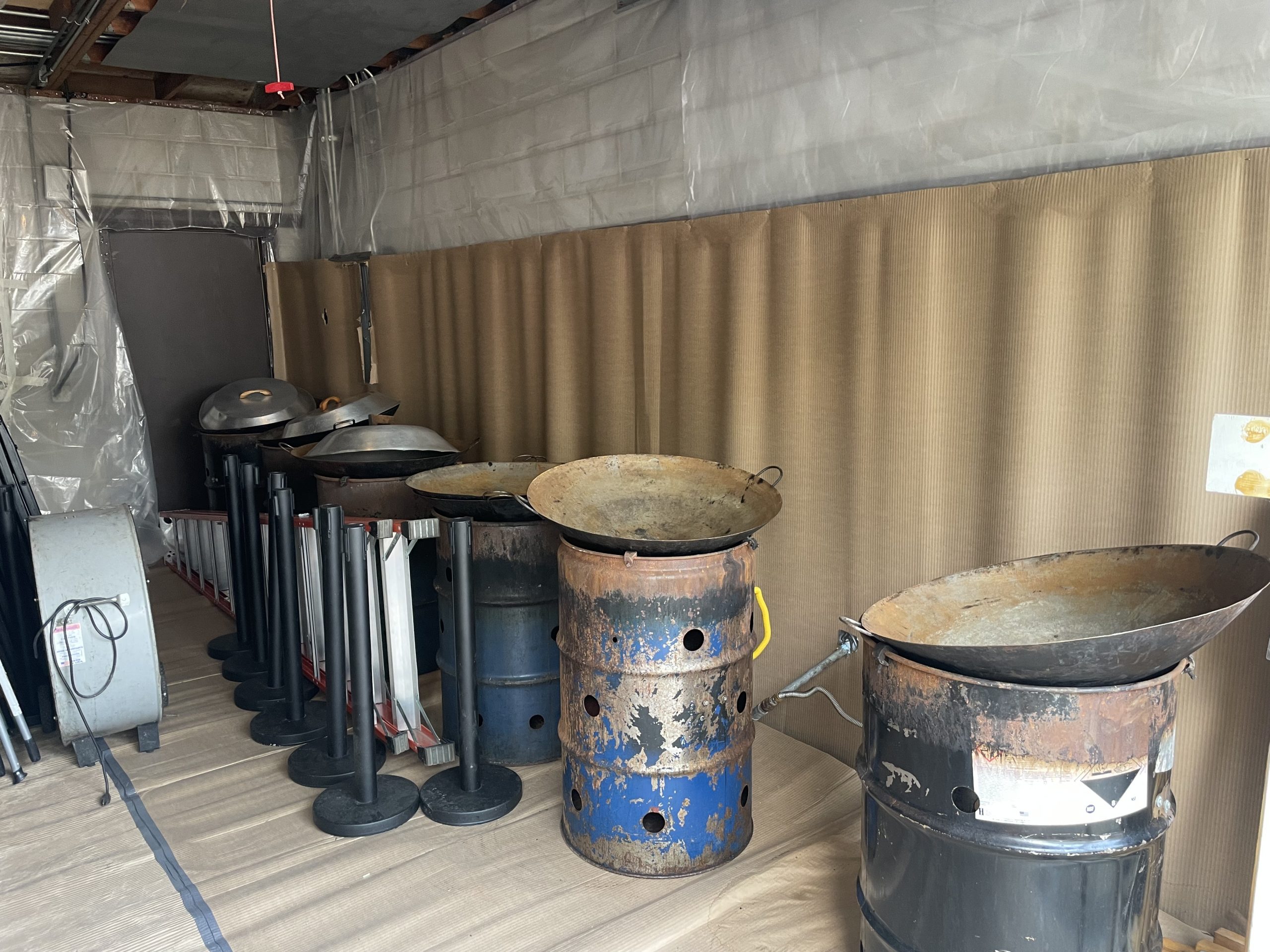

- Install gas line, barrels, and burners (GLYNN)
- Cover west and east walls with plastic
- Open/clear storage area under stage (make neat stacks of like materials – torii, gates, other – use minimal space in parking lot)
- Remove stage floor covering – check for damage and clear of nails, staples, debris
- Get floor canvas from inside (located underneath stage in social hall)
- Install floor canvas
- Install stairs
- Leave North Wall vertical studs on stage for installation on Tuesday night
- Setup Stage Wiring
- Prep Wiring for other areas
[/ap_column]
[ap_column span=”2″]
[ap_divider color=”#a17f0d” style=”solid” thickness=”2px” width=”100%” mar_top=”20px” mar_bot=”20px”]
Sunday the week Before Ginza

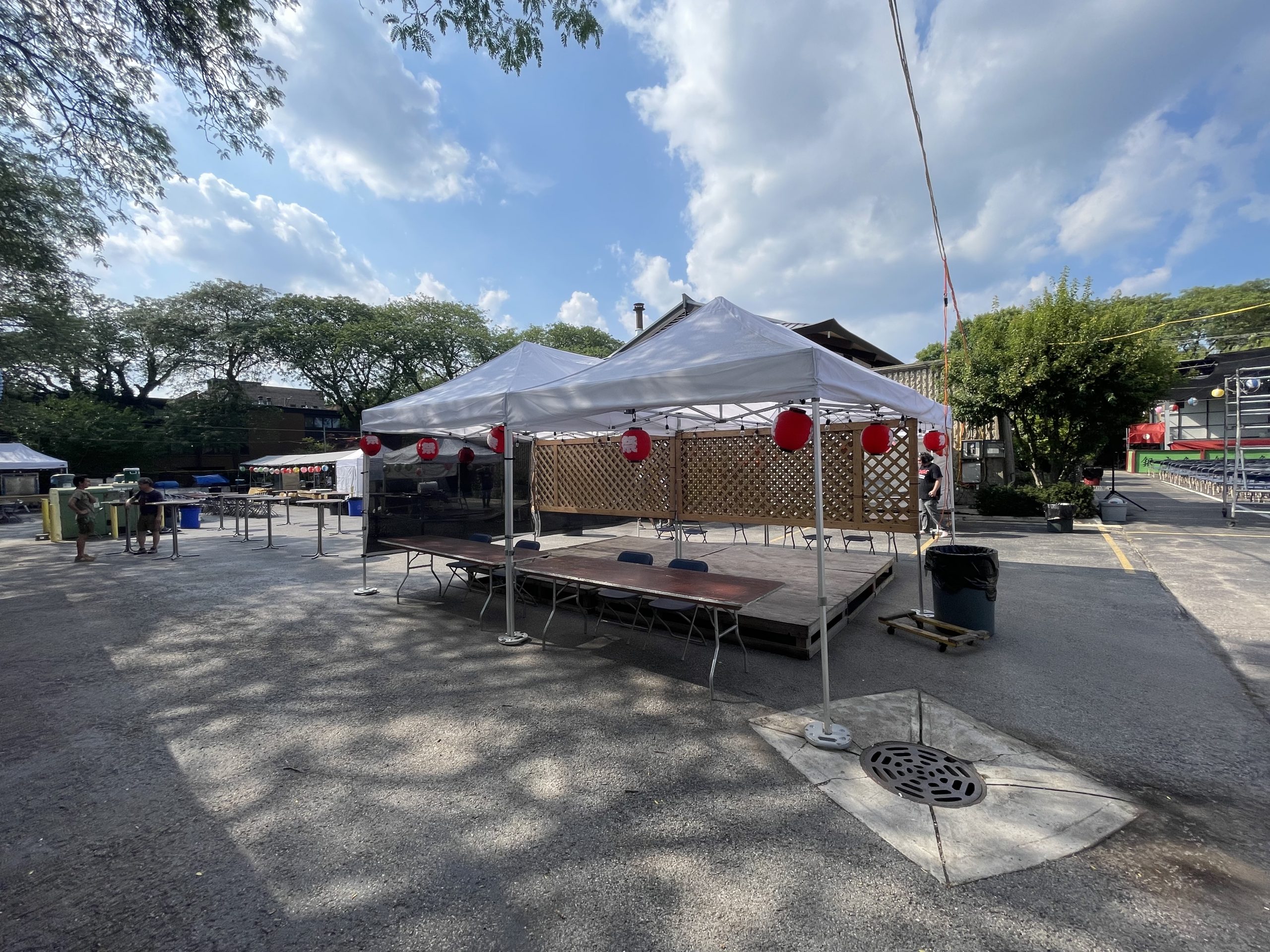

Focus: WAZA STAGE, BOOTHS, ELECTRICAL
- Build roof frame on ground
- Add roof tarp while roof is on the ground

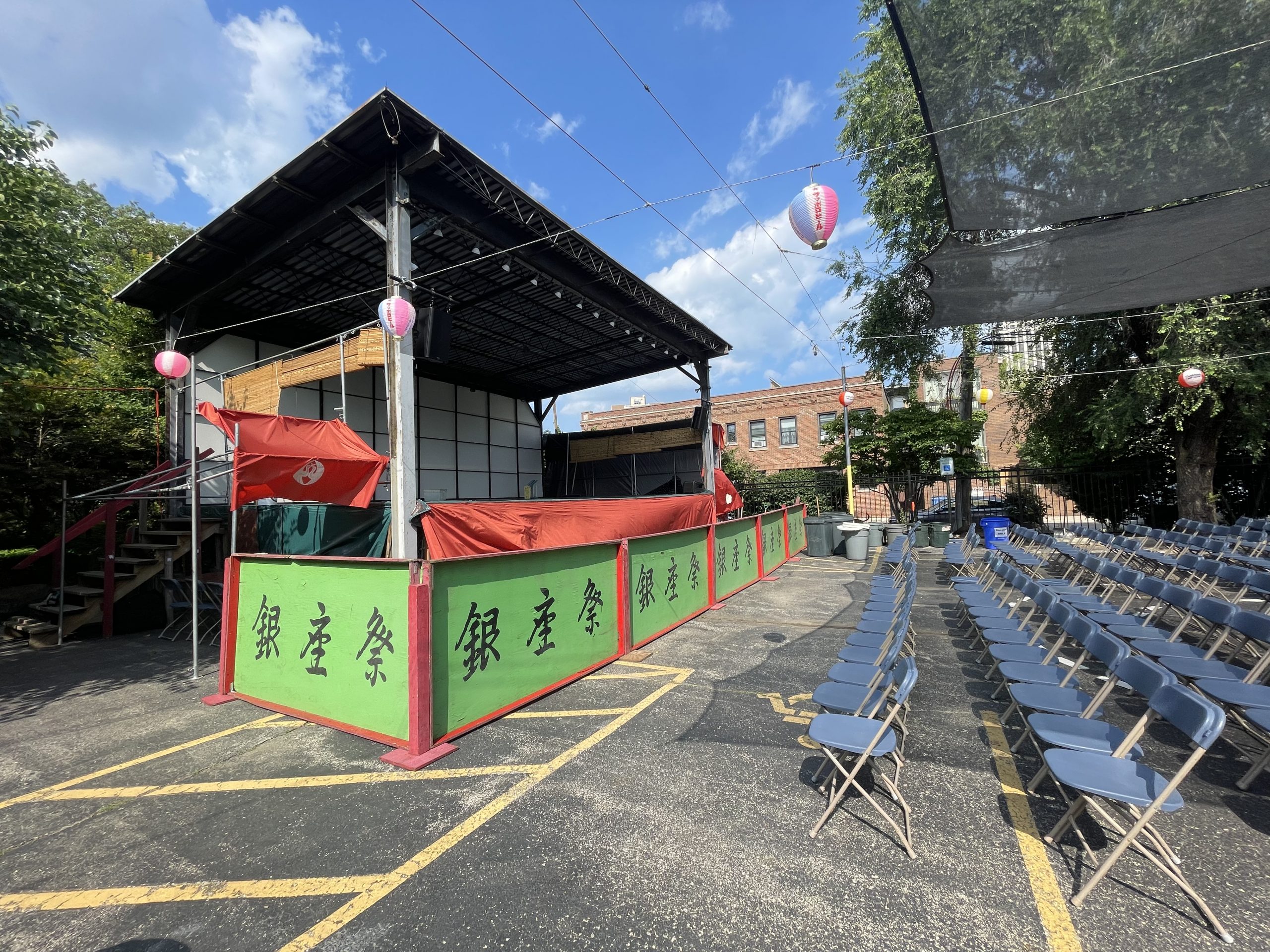

- Raise the roof
- Wire South parking lot overhead light lines
- Wire Booths for Chochins
- Setup Stage Wiring
- Prep Wiring for other areas as needed
[/ap_column]
[ap_column span=”2″]
[ap_divider color=”#a17f0d” style=”solid” thickness=”2px” width=”100%” mar_top=”20px” mar_bot=”20px”]
Weekdays Leading up to Ginza
Focus: GATES, STAGE, FINISHING TOUCHES
- General Sales Booths (new pop-up tents)

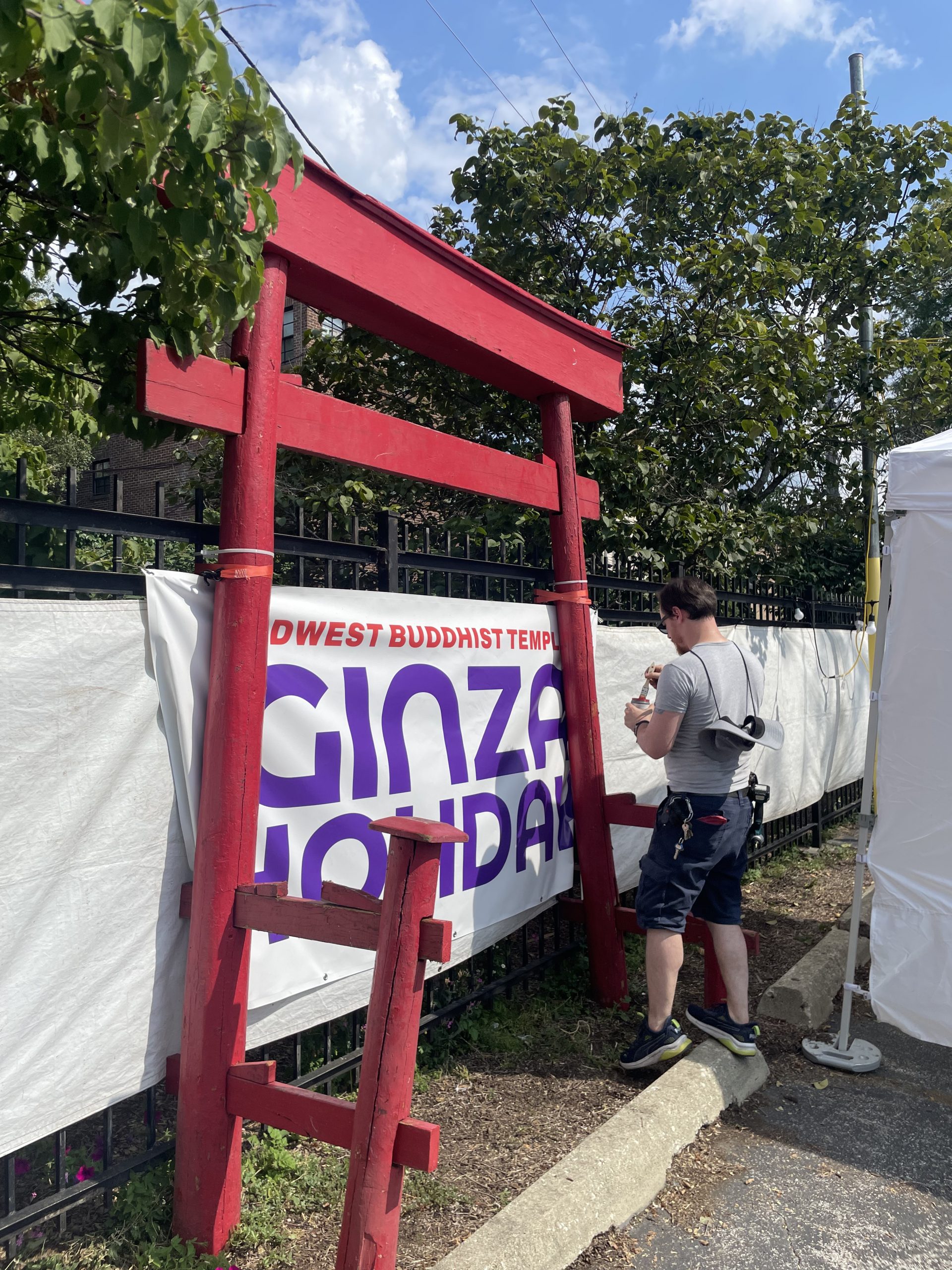

- Build North/South Gates framing (Torii for North Gate only)
- Build Food Concession Stand
- Clean Chicken Barrels
- Install stage lights
- Cover stage Left/Right Panels
- Install stage side blinds
- Install the valances under the roof trusses
- Build Stage North Wall – put up frames and screens
- Cover Food Concession Tables with Plastic (do not cover dinning tables or booth tables)
- Place uncovered tables at the front of each booth
- Install Stage Top Valence
- Install Stage curtain
- Install sun screen over seating area
- Finish booth lights wiring
- Install Chochins
- Install decorative barrier in front of stage
- Inside-Set up tables in Working Dining room
- Catch up on any unfinished tasks

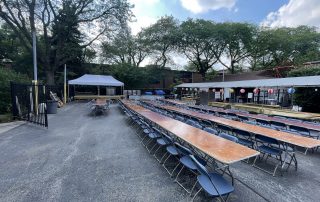

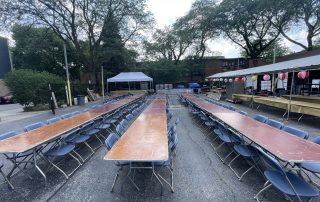

- Set up tables/chairs in Dining area (do not cover tables)
- Install shoji screen for Bonsai (social hall by washrooms)

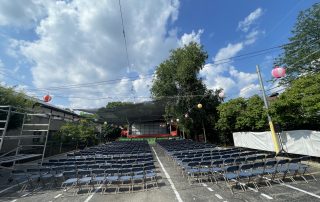

- Set up audience chairs
- Set out trash cans (with liners)
